The Future of Blue River Road
Thank you to everyone who gave feedback about the future of Blue River Road! Kansas City officials are moving forward with the first phase of restoration of Blue River Road - which will focus on the abandoned roadway segment from Chestnut Drive to Bannister Road in Council District 6. This portion will be converted into an all-purpose trail, which is currently under design.
City officials are still exploring restoration options on other closed portions of Blue River Road. Future reconstruction of the roadway could be implemented if funding is allocated towards those efforts.
Blue River Road was first built by Jackson County in 1929 and has experienced multiple structural failures over the years. Today, several portions of the road are closed due to safety and structural issues.
Phases
PUBLIC ENGAGEMENT PHASE 1
Area of Impact:

Blue River Road Options:

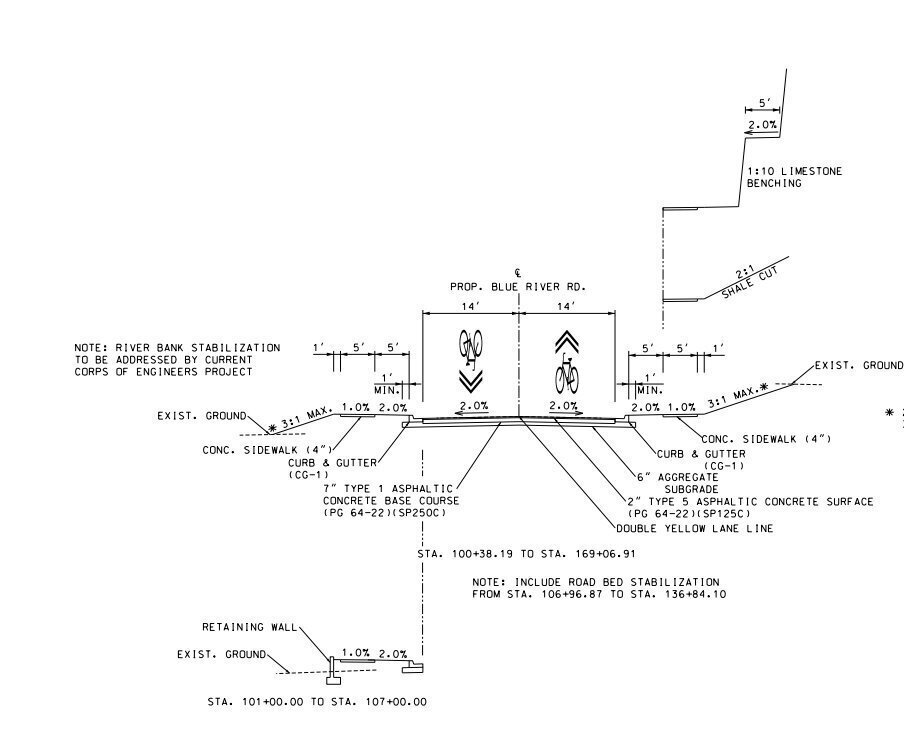

Option 1A - Rebuild Existing Alignment - $30M - $46M
- Rebuild to modern standards on existing alignment
- Shift road 20-ft into bluff
- 2 x 12-ft lanes
- 2 x 5-ft sidewalks
- Streambank stabilization

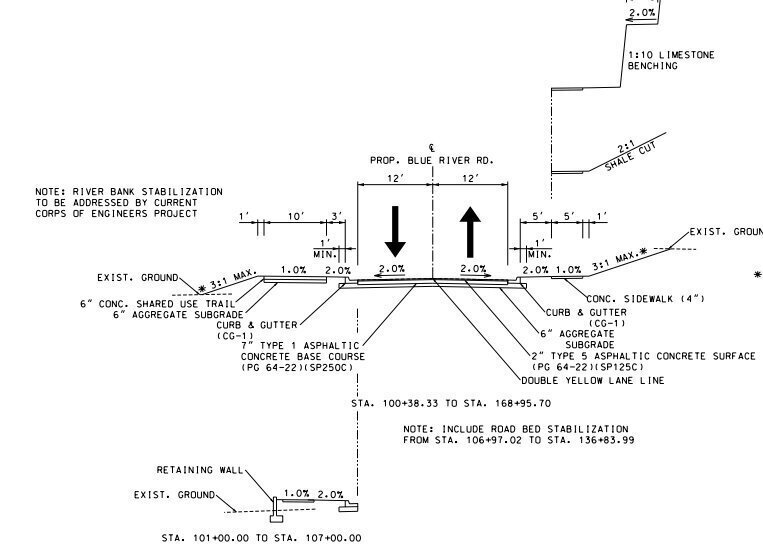

Option 1B - Rebuild Existing Alignment with Shared Path - $31M - $48M
- Rebuild to modern standards on existing alignment
- Shift road 20-ft into bluff
- 2 x 12-ft lanes
- 1 x 10-ft shared path
- 1 x 5-ft sidewalk
- Streambank stabilization

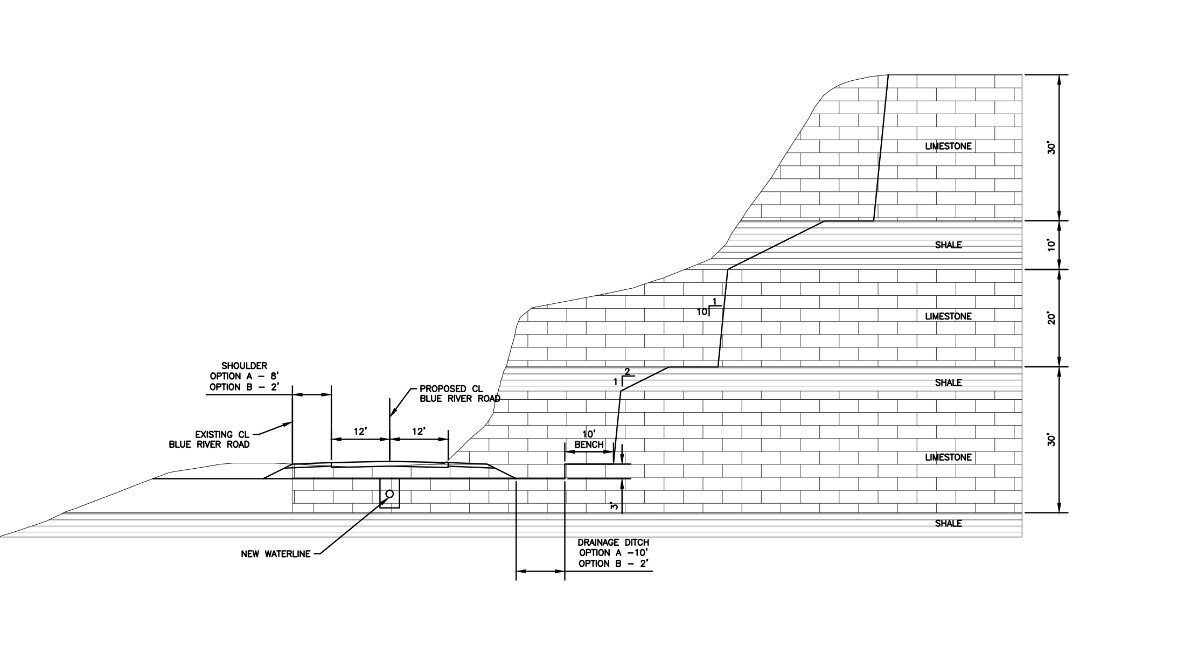

Option 2 – Shift Road into Bluff - $29M to $50M
- Shift roadway 60-ft into bluff
- Roadway rests on top of Limestone for stability
- 2 x 12-ft lanes
- 1 x 10-ft shared use path
- Drainage improvements

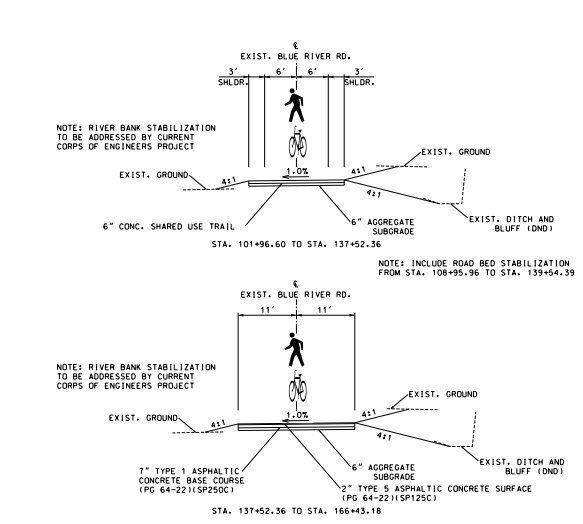

Option 3A – Shared Road to Fields, Trail Only to the South - $19M
- 22-ft wide roadway to football fields
- 2-way traffic on shared use road
- 18-ft wide trail only between football fields and Chestnut
- Stream bank stabilization

Option 3B – Roundabouts, One Way Traffic South of Fields - $20M
- 22-ft wide roadway with roundabouts at baseball fields and at Chestnut
- One-way SB road 18-ft wide shared use in between
- Stream bank stabilization

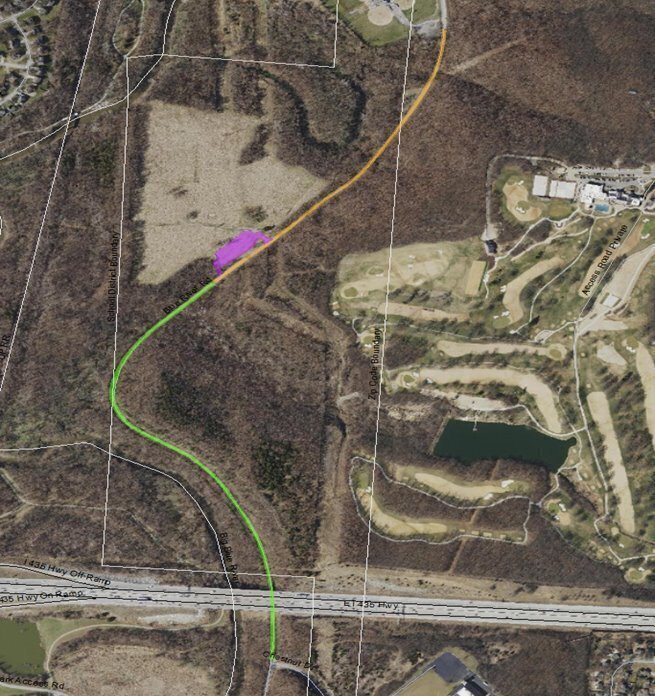

Option 4 – Road Closure and Trail - $1M to $2M
- Walking Trail
- Microsurfacing and Pavement Marking
- Starting 890 feet south of Bannister and extending to the south side of the gravel parking lot.
- Removal of pavement with an approximate pavement thickness of 10 inches.
- Grading and placement of removed pavement (millings) to serve as the trail base.
- Paring Lot
- Grading and Placement of removed pavement (millings) in the gravel parking lot.
- Adding parking area at southern terminus at Chestnut Drive
- Similar treatment from Hickman to Prospect
- No streambank stabilization

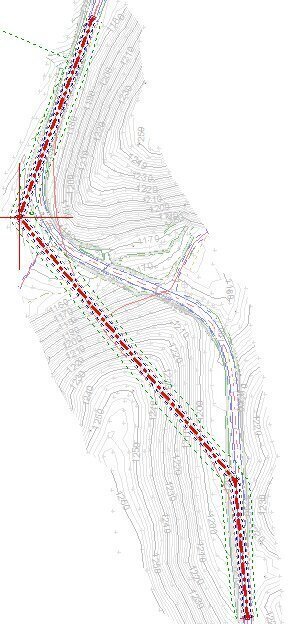

Option 5 – Move the roadway to East - $42M
- Realign new roadway through hill

Kansas City staff wants to hear your input on the future of Blue River Road! Click on "Submit a comment" and leave your thoughts here.
